Also called: basal reinforced piled embankment, geosynthetic-reinforced pile-supported embankment, GRPS

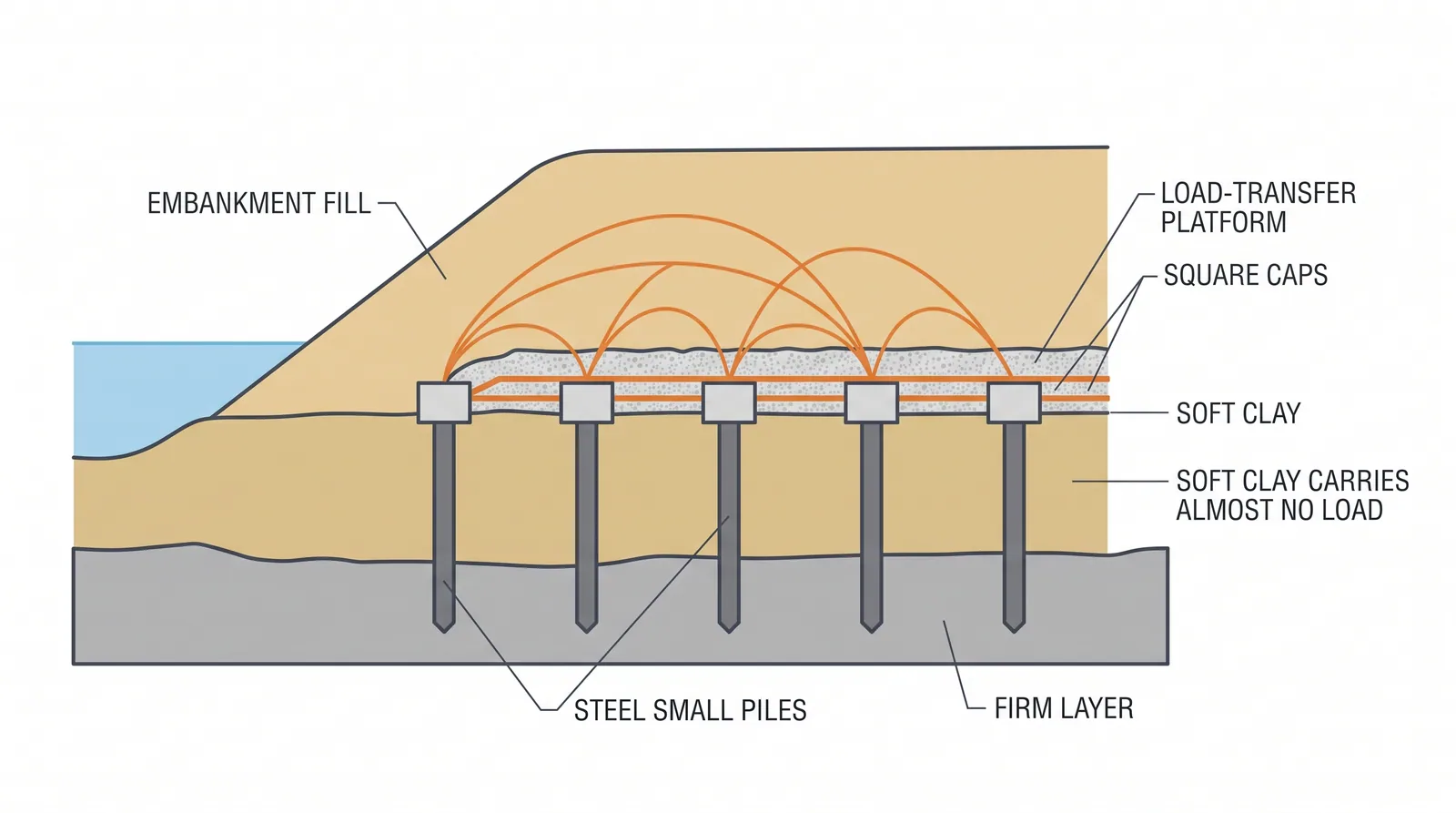

Concept diagram (TheBridgeEng)
How it is done Install piles (driven concrete, timber, CFA, DCM or stone columns) on a 1.5-3 m grid with caps 0.6-1.2 m square. Place one to three layers of high-strength geogrid in a 0.5-1 m granular platform. Build the embankment; the platform arches the load onto the caps within about 1 m of fill height.
Where it fits Approaches on very soft or organic soil, where the programme is short, or where the approach must not settle against a fixed abutment. Where it does not Thin soft layers where PVDs are far cheaper.
Plant, pace and money Plant Piling rig, earthmoving, geogrid laying crew.
Productivity Piling dominates: 40-80 piles per rig per day.
Cost USD 150-400 per m2 of embankment footprint, two to four times a PVD scheme, but no waiting.
Risks and controls What goes wrong Punching of caps through the platform if the geogrid is under-designed; lateral spreading at the embankment toe. Quality assurance Pile records, geogrid overlap and tension checks, settlement plates on caps and between them.
Examples Dutch and Scandinavian railways, Korean high-speed rail approaches, Bangkok expressway ramps.
Related methods
Further reading BS 8006-1 · CUR 226 (Dutch design guideline)
