Also called: truss erection, panel-point erection, truss bridge construction

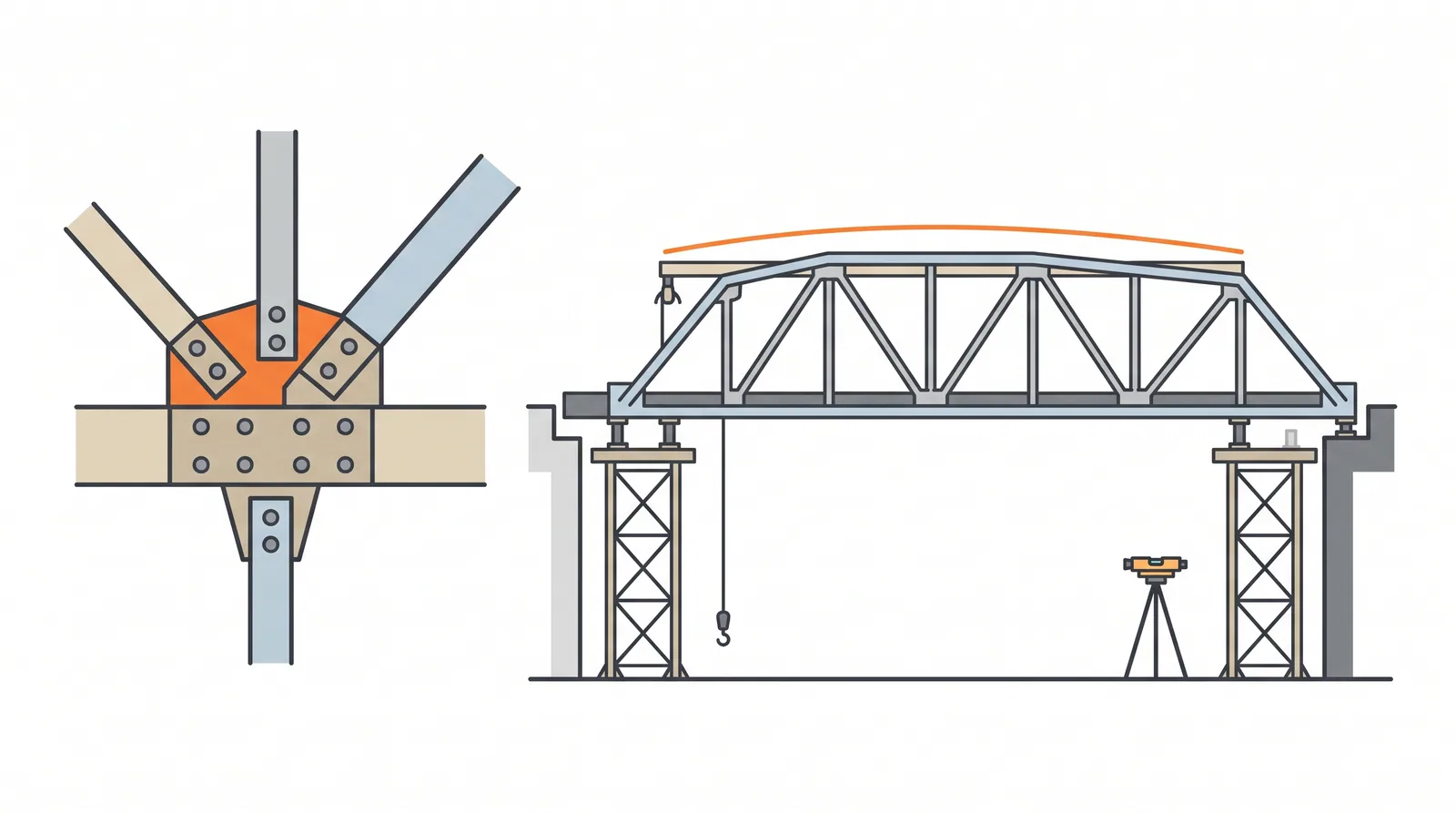

Concept diagram (TheBridgeEng)
How it is done Shop-fabricate members with drilled connections from a matched assembly; trial-assemble in the shop for long spans. Erect on temporary towers (short spans), by cantilever with a derrick (long spans), or fully assembled on shore. Bolt panel points progressively; install the deck system and bracing to stabilise the trusses. Survey camber and alignment continuously; adjust with temperature in mind.
Where it fits Rail bridges, long-span river crossings, sites where the deck must be shallow for clearance, floating or sliding in complete trusses. Where it does not Sites without room for assembly or without lifting capacity; highly repetitive short spans where girders are cheaper.
Plant, pace and money Plant Cranes, derricks, temporary towers, bolting crews.
Productivity One panel per day on towers; slower by cantilever.
Cost Steel USD 4,000-8,000 per tonne fabricated and erected.
Risks and controls What goes wrong Gusset plate deficiencies (I-35W), member buckling during erection, misfit at closure. Quality assurance Shop trial assembly, gusset design check, bolting inspection, survey.
Examples Ikitsuki (400 m continuous truss), Japanese and Chinese rail-road trusses, US Mississippi trusses.
Related methods
Further reading AASHTO LRFD 6 · NCHRP gusset plate guidance
