Construction methods · Site investigation and testing
Karst and cavity probing
In limestone and other soluble rock, every pile can meet a void. Probing below each foundation location, and often below each pile, finds cavities before the drilling rig does.
Also called: probe holes, cavity investigation, grouting investigation

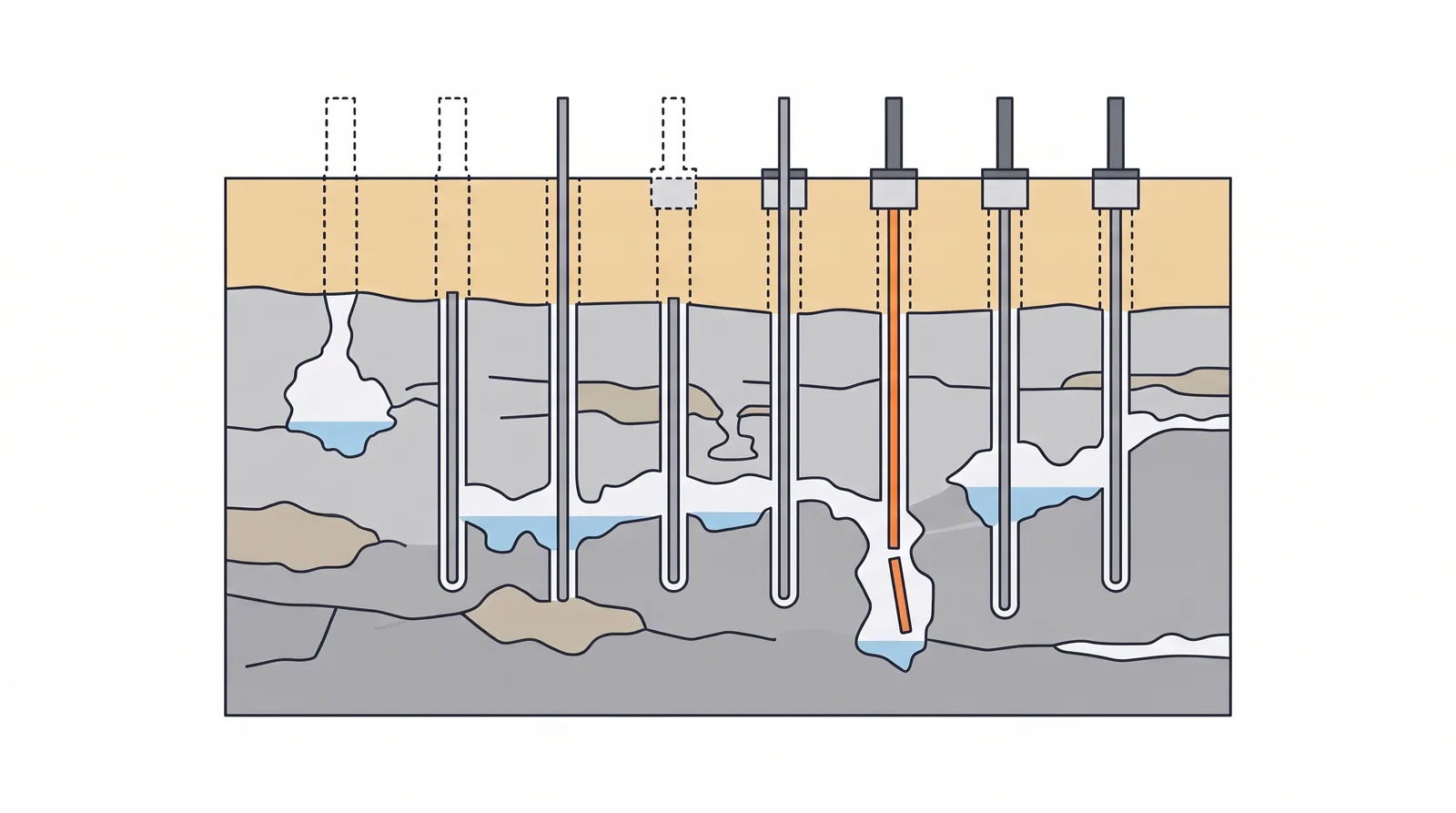

Concept diagram (TheBridgeEng)
How it is done
Drill open-hole probes at each pile position to 3-5 m below the design socket base; record drill rate and water loss.
Where voids or clay-filled fissures are found, deepen the pile, relocate it, or grout the void before piling.
Use cross-hole sonic or resistivity between probes where the spacing is wide.
Where it fits
Limestone, dolomite, gypsum and coral rock; any site flagged as karst in the desk study.
Where it does not
Sizing sockets on a single borehole in karst.
Plant, pace and money
PlantSmall rotary or DTH rigs; grouting plant if treatment follows.
ProductivityOne or two probes per pile per shift.
CostAdds 5-15 % to piling cost in karst; far cheaper than a lost pile.
Risks and controls
What goes wrong
Voids between probe positions; sudden drill drops during production piling.
Quality assurance
Drill logs with rate and water loss for every probe; a void register tied to pile numbers.
Examples
Kuala Lumpur limestone, Florida, parts of the Gulf coast; the game's karst sites trigger the karst void event when bored piles are used without probing.
